Automated Warehousing Integration: What Fails First on Site

Automated Warehousing Integration: What Fails First on Site

Author

Prof. Alaric Sterling

Time

Click Count

Where Automated Warehousing Integration Usually Breaks First

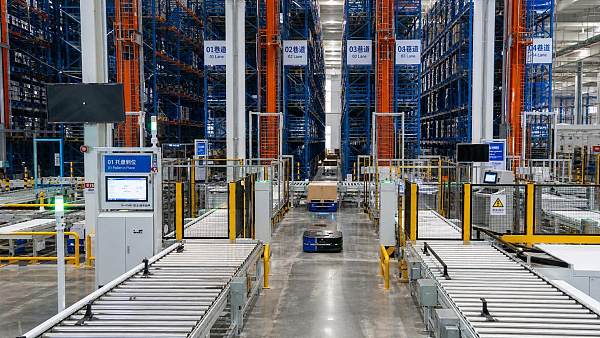

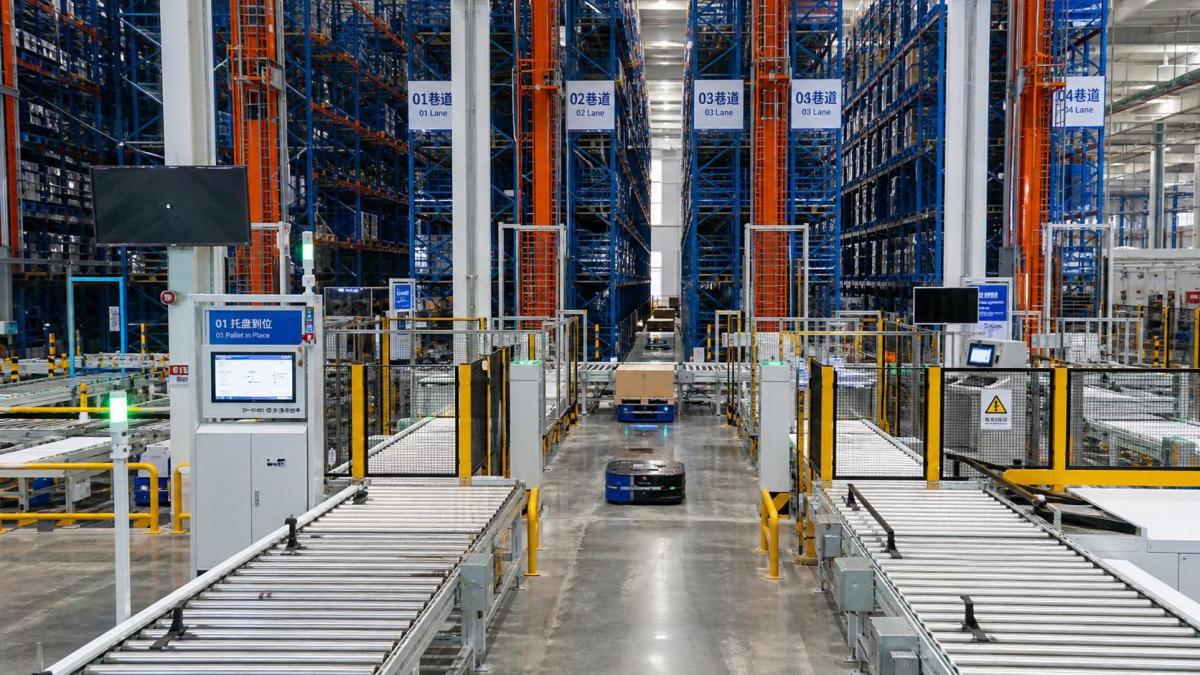

Automated Warehousing Integration: What Fails First on Site

Automated warehousing integration rarely fails at the first software demo. It usually starts failing when real equipment meets real building limits, real traffic, and real operating pressure.

That matters across factories, logistics hubs, ports, workshops, and mixed industrial sites, where conveyors, AGV forklifts, stackers, cranes, and manual handling often share the same workflow.

In practice, the first issues are more physical and procedural than digital. Layout mismatch, undefined interface ownership, unstable data timing, and poor installation sequencing appear before optimization begins.

For any automated warehousing integration project, the real question is not whether automation works in principle. The question is whether the site can support it without hidden friction.

Why the Same Integration Plan Behaves Differently on Different Sites

Two warehouses may store similar pallets and still need very different integration logic. One may prioritize throughput, while another is constrained by clearance, floor flatness, or mixed vehicle traffic.

Automated warehousing integration changes character when the site mixes narrow aisle vehicles, overhead lifting, battery charging, packaging lines, and ERP or WMS handshakes.

A high-bay e-commerce facility usually cares about data latency, slotting speed, and wave release accuracy. A heavy industrial warehouse often worries first about load stability, safety zoning, and equipment interference.

This is why early judgment should start with operating conditions, not catalog specifications. The same shuttle, conveyor, or automated crane can perform very differently under different site rhythms.

A quick comparison of site priorities

Site condition What fails first Main judgment point
High-throughput carton flow Data timing and release logic Whether upstream and downstream signals stay synchronized
Pallet warehouse with AGV forklifts Traffic conflict at transfer points Whether route design matches loading behavior
Heavy-load industrial storage Mechanical alignment and safety clearance Whether lifting paths, rails, and floor tolerances are realistic
Brownfield retrofit Interface ownership confusion Whether each handoff point has one clear responsible party

In Fast Pallet Operations, Transfer Zones Usually Cause the First Delays

In distribution warehouses, automated warehousing integration often looks stable until pallets begin arriving in uneven bursts. Then the weak point becomes the transfer zone between systems.

The issue is rarely the conveyor alone. It is usually the relationship between pallet quality, barcode readability, AGV arrival timing, and line release rules.

A common misjudgment is assuming standard pallet dimensions guarantee reliable flow. In reality, overhang, damaged deck boards, wrapping tails, and skewed loads create repeated stoppages.

Automated warehousing integration works better here when transfer points are tested with actual load variation, not only nominal pallet data. Exception handling should be designed before commissioning, not after it.

What to confirm before go-live

  • Actual pallet dimensional tolerance under load
  • Scanner readability during peak movement speed
  • Queue logic when one lane is blocked
  • Fallback rules for manual intervention without system confusion

In Brownfield Facilities, Interface Ownership Fails Before Technology Does

Retrofit projects are where automated warehousing integration becomes less about hardware selection and more about responsibility mapping. Old conveyors, forklifts, hoists, and WMS logic create blurred boundaries.

One supplier may control mechanical installation, another controls PLC logic, and another manages host software. When a handoff fails, everyone can point to someone else.

This is often the first real breakdown on site. A sensor fault may look electrical, but the root cause may be bracket positioning. A routing delay may look software-related, but the source is an undefined signal owner.

The better approach is simple and strict. Every signal, stop condition, transfer confirmation, and recovery action should have one named owner and one validation method.

For automated warehousing integration in older buildings, the interface list is often more important than the equipment brochure. That is especially true where manual forklifts still work beside automated lanes.

Heavy Loads and Vertical Storage Change the First-Risk Profile

In facilities handling large components, coils, molds, or dense pallet loads, automated warehousing integration is shaped by mechanics first. Travel speed matters less than positional stability and clearance discipline.

This is where automated cranes, stacker systems, overhead lifting, and guided transport need tighter coordination. A few millimeters of rail deviation or rack misalignment can become a repeating fault source.

More importantly, heavy-load sites often mix automated handling with manual lifting support. That creates operational overlap, and overlap creates uncertainty unless zoning, access logic, and lockout rules are clear.

A frequent mistake is evaluating automated warehousing integration only through rated capacity. Rated capacity says little about vibration, sway, load center variation, or approach precision under actual site conditions.

On these sites, acceptance tests should include realistic loading sequences, emergency stops, restart behavior, and recovery after incomplete picks. Paper capacity alone does not protect commissioning schedules.

Data Flow Problems Usually Appear as Operational Confusion

When automated warehousing integration loses data stability, the symptom on site is not always a system alarm. It can appear as double allocation, missing pallets, stranded missions, or operators waiting without explanation.

The problem becomes more visible in mixed environments where ERP, WMS, WCS, AGVs, scanners, battery systems, and IoT monitoring exchange events at different speeds.

In practical terms, unstable data flow often starts at small points. Time stamps differ. Inventory status changes too early. A completed move is recorded before the load is physically confirmed.

That is why automated warehousing integration should be tested by transaction sequence, not just by interface connection. A healthy handshake is not enough if business logic is still out of order.

Typical signs that data logic is drifting

  • Inventory shows movement before physical transfer finishes
  • Equipment waits for release despite clear downstream space
  • Recovery after faults creates duplicate transport orders
  • Manual override breaks location accuracy for later cycles

Installation Sequencing Is an Underrated Integration Risk

Many automated warehousing integration projects slip because installation order does not match commissioning logic. Civil work, racks, charging areas, guarding, controls, and software readiness move on different calendars.

The result is familiar. Equipment is physically present but cannot be tested. Or software is ready, but access routes, power isolation, and safety fencing are still incomplete.

This becomes more difficult in multi-equipment environments, especially where reach trucks, AGV forklifts, conveyors, automated cranes, or lithium-ion charging systems share infrastructure.

A useful rule is to sequence installation by dependency, not by supplier convenience. The first commissioning path should be visible long before the full system is assembled.

What Gets Misread Most Often During Automated Warehousing Integration

The biggest errors are usually judgment errors. They do not look dramatic at first, but they create expensive friction later.

  • Treating similar sites as identical, even when traffic density and load variation differ
  • Reading equipment capacity without checking aisle geometry, floor condition, and service access
  • Focusing on purchase scope while ignoring commissioning labor and recovery logic
  • Assuming safety compliance is a final inspection item rather than a design input
  • Testing normal flow carefully, while leaving exception flow vague

In the broader material handling sector, these mistakes matter because uptime, safety, and lifecycle cost are linked. Integration quality influences all three at once.

A More Reliable Way to Prepare the Next Integration Stage

The most reliable automated warehousing integration projects usually start with a sharper site review, not a longer feature list. Real conditions should be translated into validation checkpoints.

That means mapping load types, transfer points, signal ownership, manual interaction zones, recovery routines, and commissioning dependencies before final execution begins.

It also helps to compare conditions across similar applications. A pallet warehouse, a heavy industrial store, and a port-side buffer area may all automate movement, but the first failure triggers are not the same.

The next step is straightforward. Document the site-specific constraints, test the weak handoff points first, and build acceptance criteria around real operating exceptions, not ideal flow alone.

That approach makes automated warehousing integration more predictable, and it reduces the gap between engineered intent and on-site performance.
